Frequent roadblocks caused by landslides at Box-Cut along the Gelephu–Zhemgang highway have long caused travel disruptions, especially during the monsoon. But with the ongoing construction of the 19.3-kilometre Box-Cut Bypass, commuters may soon enjoy a safer and more reliable route.

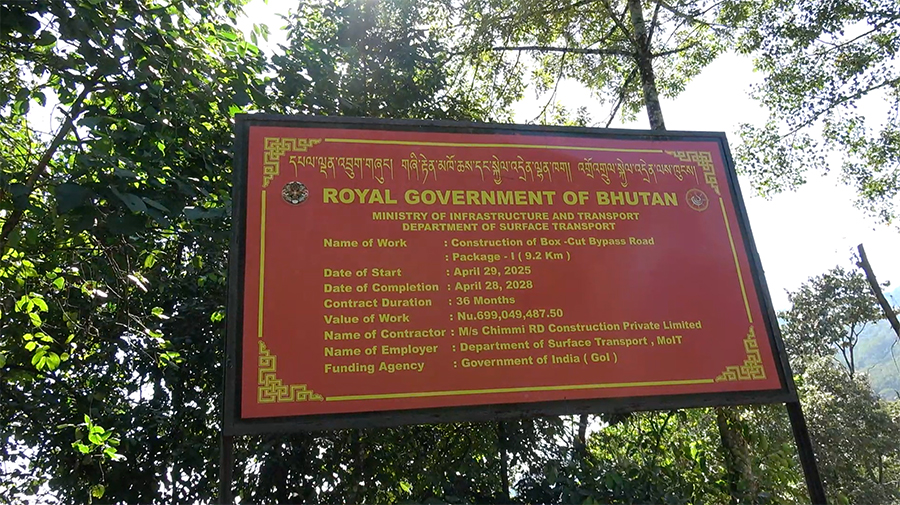

The first package of the project, covering 9.2 kilometres, began in April this year.
It includes the construction of five bridges.
Works are expected to be complete in 2028.

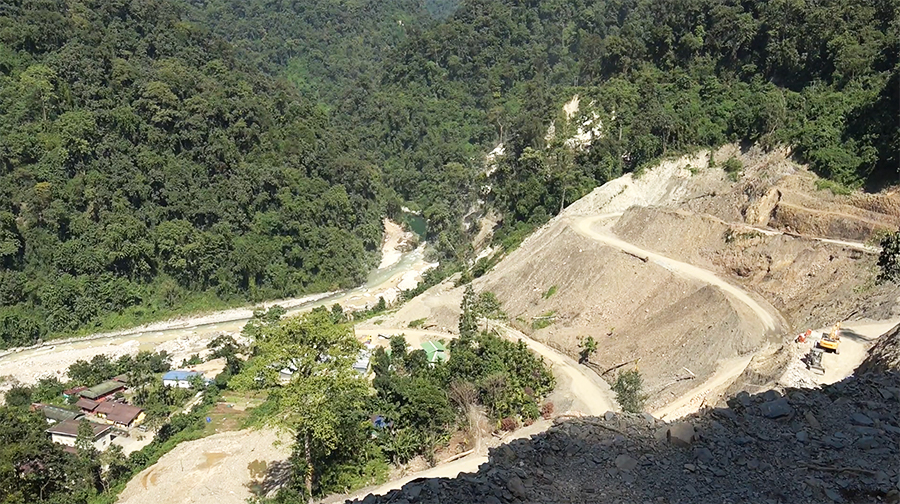

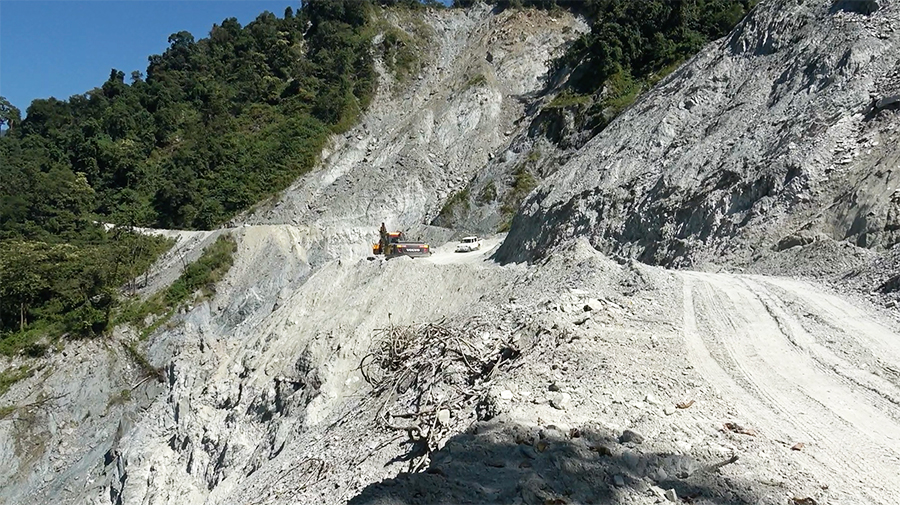

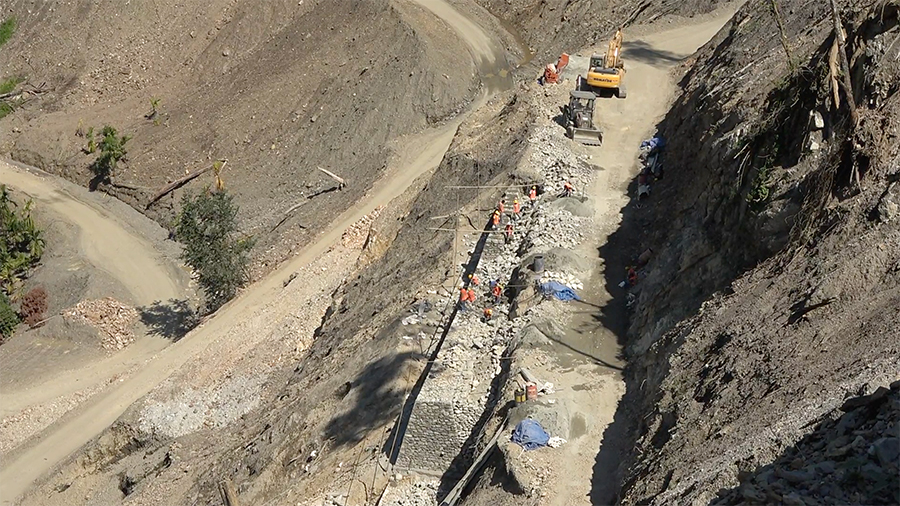

For now, about two kilometres of the first cutting have been completed between Chorten and Tsachu area.
Sonam Tamang, Site Supervisor, Chhimi RD Construction said, “We have so many problems as we have to do first cutting work. In some places, we are unable to reach road alignment point and have to do first cutting at different places. In summer, we face many problems with rainfall.”
For commuters, the bypass promises a safer route from years of road closures and delays.
Tek Nath Gurung, a commuter said, “I am from Suray in Jigmechhoeling Gewog, but because of the poor road condition, I have been living in Gelephu. Once the bypass is complete, I would prefer to move back to my village.”
Dil Bahadur Gurung, another commuter said, “This project will really benefit all of us. Since childhood, the Box-Cut road has always been a problem. The new bypass will not only help people here but also those travelling to Zhemgang and Trongsa.”
Indra Gurung, a resident of Jigmechhoeling said, “The Box-Cut road has been giving us a lot of trouble. It is steep, and even in winter, there are falling boulders, forget about the monsoon. Many vehicles have been damaged and people have suffered big losses. The new road across the river will be much safer and a big help for everyone.”
According to the Department of Surface Transport, the overall physical progress under Package 1 stands at 4.45 per cent.
Works for package 2 is currently being re-tendered and is expected to begin by next month.
Karma Wangdi, Gelephu
